What to Expect During a Roof Replacement: A Complete Homeowner's Guide
What to Expect During a Roof Replacement

Getting a new roof is one of the largest single investments most homeowners make. It is also one of the least understood. Most people have never been through the process before, and by the time a replacement is necessary, the urgency of the situation does not leave much time to figure out what actually happens from start to finish.
This guide walks you through every phase, from the first inspection call to the final walkthrough, so you know what is coming, what questions to ask, and how to tell whether the job is being done right.
The Full Timeline: More Than Just Installation Day
The most common misconception about roof replacement is that the project begins and ends with the crew arriving at your home. Most roof replacements take between one and three days to install, especially for asphalt shingles on average-sized homes. However, from the first consultation to the final cleanup, the total project timeline can extend over two to three weeks. This full timeline includes scheduling inspections, ordering materials, removing the old roof, making repairs to the roof deck if needed, installing the new system, and completing the final walkthrough and cleanup.
Planning for the full timeline rather than just the installation window prevents surprises and helps you coordinate around the project sensibly.
Phase 1: Inspection and Estimate (Days 1 to 3)
The first step is the inspection. A reputable contractor does not estimate a roof replacement over the phone or based on satellite imagery alone. They send someone to physically inspect the surface, check the attic, evaluate flashing and ventilation, and measure the roof to establish an accurate material quantity.
A thorough estimate from roofing companies near me should be fully itemized. It should cover material costs by type and tier, tear-off and disposal fees, decking repair pricing if needed, flashing and underlayment specifications, permit costs, and a clear statement of what is not included. Any contractor who hands you a single-line quote with just a total number is giving you an incomplete picture.
Get your estimate, review it carefully, and compare at least two or three quotes before signing anything.
Phase 2: Permits and Material Ordering (Days 3 to 10)
Once you select your contractor and approve the estimate, they will pull the required building permit and order your materials. This phase is invisible to you but essential.
It is important to finalize your shingle color selection before the contractor can proceed with ordering the materials. This will help the contractor plan the project accordingly and avoid any delays. If you have a homeowner's association, confirm your color choice is approved before materials are ordered. Changing your mind after materials arrive creates cost and delay.
Permit processing times in Indiana municipalities vary. Some issue same-day permits, others take a week or more. Your contractor handles this but should keep you informed of where the permit stands. Never allow work to begin without a valid permit in place. An unpermitted roof replacement creates complications when you sell the home and may affect your insurance coverage.
You might expect a dumpster to be delivered to your home one to two days before the new roof installation starts. Discuss with your contractor the specifics on timing and ideal placement for the dumpster to avoid vehicles getting trapped in the driveway or garage you can refer roof repair near me.
Phase 3: Installation Day or Days
This is where the work happens. Here is what to expect at each stage.
Early morning: crew arrives and materials are staged
The crew typically arrives at or shortly after sunrise. If materials were not pre-loaded to the roof, they will be lifted or pulled up at the start of the day. Move any vehicles out of the driveway before the crew arrives. Roof debris during tear-off falls straight down, and anything parked alongside the house is at risk of minor damage.
Tear-off
The first major step in the roof installation process is the roof tear-off. A roof tear-off is the complete removal of shingles, underlayment, and flashing, stripping your roof down to the roof deck. In some cases, roofers may have to replace portions of your roof deck if there are signs of rot or other damage. The roofing team will bring a dumpster into your driveway to easily toss debris from the roof.
Tear-off is the loudest and most disruptive phase of the entire project. You will hear constant prying, scraping, and debris impact. If you work from home, plan accordingly. If you have young children or pets who are sensitive to noise, arrange for them to be elsewhere during this phase.
Decking inspection and repairs
On day one, crews carefully remove old shingles and inspect the underlying structure. If repairs to roof decking or framing are needed, they are usually done the same day.
This is also when any surprise costs emerge. Rotted or damaged decking boards that could not be identified from the surface become visible once the shingles come off. Your estimate should include a per-sheet price for decking replacement so you know exactly what any additional work will cost before the crew proceeds.
Underlayment installation
Once the decking is confirmed sound, the crew installs the underlayment system. In Indiana's climate, this includes ice and water shield along all eaves and valleys at a minimum, which is required by Indiana building code. Quality underlayment covers the full deck surface. This layer is your backup protection against any water that gets past the shingles.
Shingle installation and flashing work
By day two, new underlayment and new shingles are installed. Crews work efficiently, but weather delays or unexpected structural issues can affect the timeline.
New flashing is installed at every penetration point: chimneys, skylights, vents, and valleys. Proper flashing work is painstaking. Shortcuts here are one of the most common sources of post-replacement leaks, so watch that it is not being rushed.
Ridge cap shingles are installed last, sealing the peak of the roof and completing the visual line of the finished installation.
Phase 4: Cleanup and Walkthrough

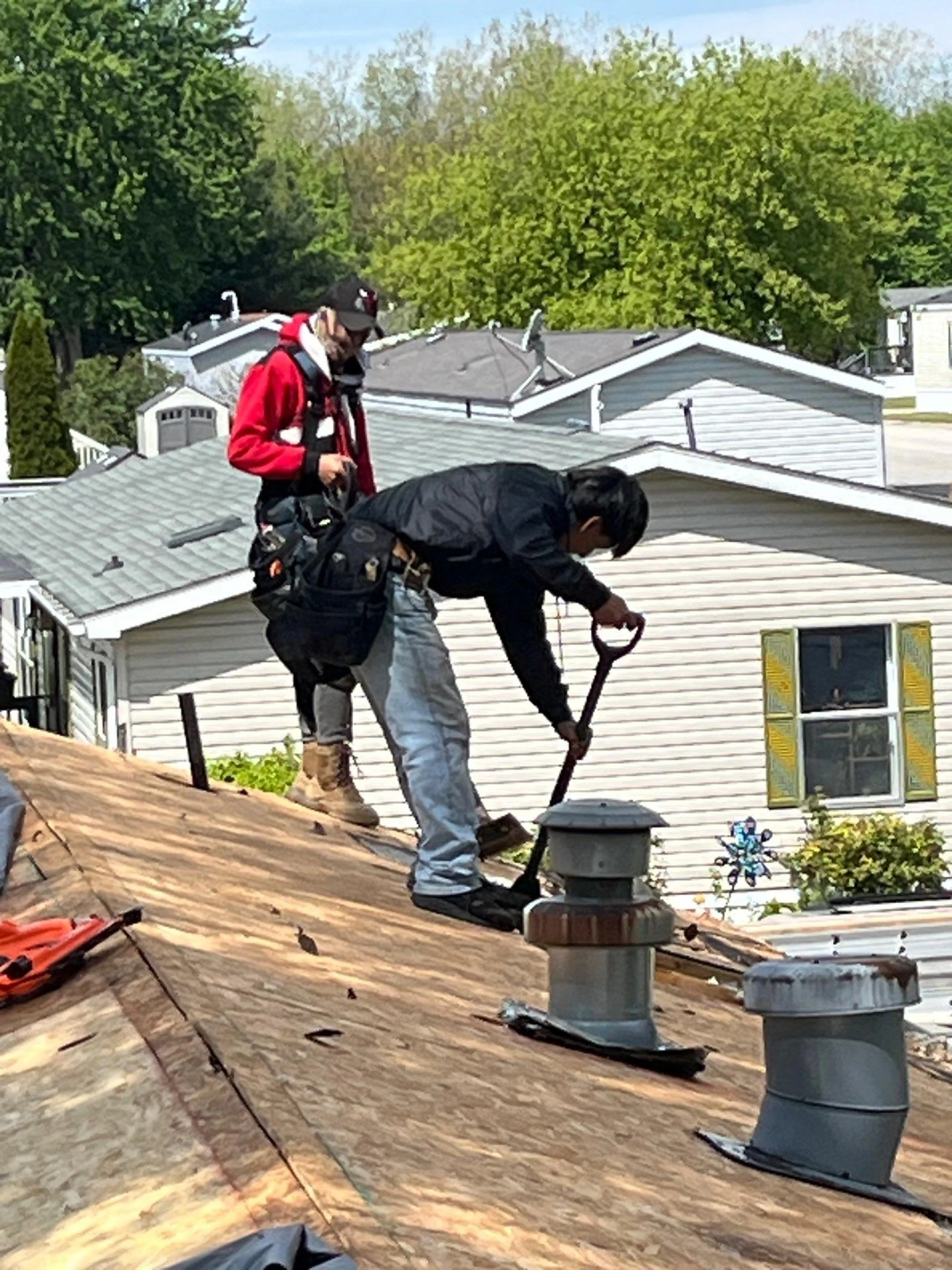

Cleanup is not an afterthought. A professional crew performs a thorough magnetic sweep of the yard, driveway, and any landscaped areas around the perimeter of the home to collect stray nails. They remove the dumpster, take down any staging material, and leave your property in clean condition.
Reputable roofing companies take cleanup seriously. Crews will leave your home looking as good or better than before.
After cleanup, you should be walked through the finished work. Ask to see photographs of any decking repairs made during the project, and confirm that all flashings were replaced, not simply reused from the old roof. Get the permit inspection documentation if your municipality requires a final inspection, and make sure all warranty paperwork is provided in writing before the crew leaves.
What Affects Installation Duration
A simple 1,800-square-foot single-story home with standard asphalt shingles typically wraps in one day. A 3,200-square-foot two-story home with multiple roof planes and decking repairs can take two to three days. Weather, crew size, and material availability are the three biggest wildcards.
Steep-pitch roofs require more labor time per square foot because the crew works more slowly and safely on severe slopes. Multiple valleys, dormers, skylights, and chimneys all add complexity and time. If any of these apply to your home, build an extra day into your mental timeline.
What You Need to Do Before Installation Day
A few preparation steps on your end make the day go more smoothly and protect your property.
Move vehicles out of the driveway and away from the home's perimeter the night before. Remove any hanging wall art or fragile items from interior walls directly below the roof, particularly on upper floors, as vibration from nailing can shake them loose. If you have pets, arrange for them to be somewhere comfortable and quiet for the duration. Alert your immediate neighbors that the work is happening, particularly if shared driveways or property lines are close.
Cover anything in your attic that is sensitive to dust or debris. Some fine debris can filter through during tear-off even with proper protective measures.
FAQs
Do I need to leave the house during a roof replacement? You do not typically need to vacate your home, but noise and vibration are unavoidable. Plan accordingly if you work remotely or have young children or pets.
What if it rains during my project? Experienced roofing crews manage partial-day weather delays by tarping exposed areas before leaving the site. If a full day of rain is forecast, most contractors will not begin tear-off. Your project start may be pushed back, but no reputable contractor leaves your decking exposed overnight in rainy conditions.
What happens if the crew finds decking damage? They should stop and contact you before proceeding with repairs beyond the original estimate. You are entitled to see the damage, understand what needs to be replaced and why, and approve the additional cost before work continues. A contractor who proceeds without notifying you and then presents a higher invoice afterward is not operating transparently.
Will I receive warranty documentation? Yes. You should receive both the manufacturer's warranty for the shingles and a written workmanship warranty from your contractor. File both with your home records. GAF-certified contractors like Weldon Roofing and Construction provide warranties that cover both product defects and installation workmanship, with specific terms spelled out in writing.
How soon after installation can I expect roof repair near me follow-up service if something looks wrong? Any issue that appears within the first season after installation should be covered under your contractor's workmanship warranty. Contact your contractor promptly if you notice any lifting shingles, flashing gaps, or early leaks. Do not wait through a second rain event before calling.
When is the best time of year to schedule a replacement in Northwest Indiana? Late spring through early fall offers the most stable weather conditions for roof work, reducing the chance of rain delays and allowing materials to seal properly. During peak season, schedule four to eight weeks in advance. During off-peak months, lead times are typically two to four weeks. Fall installations before the first hard freeze give you the best combination of installation conditions and winter protection.
