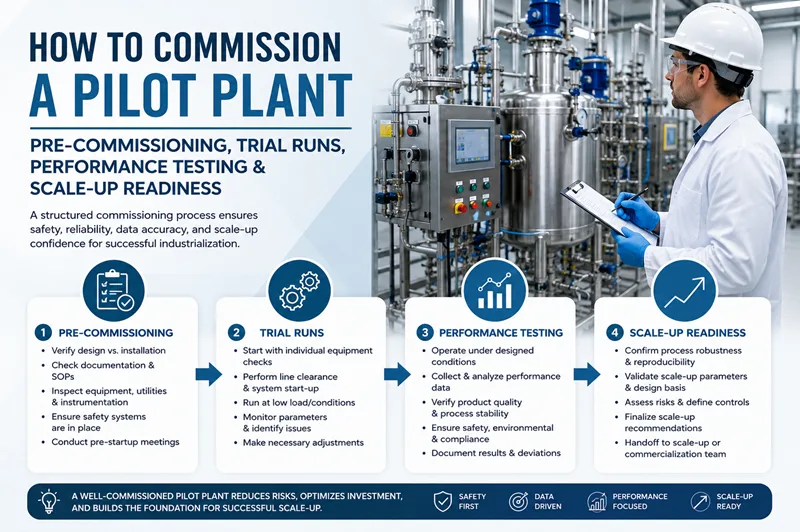

How to Commission a Pilot Plant: Pre-Commissioning, Trial Runs, Performance Testing & Scale-Up Readiness

If you have just finished building a pilot plant, there is a natural temptation to load the raw materials, hit start, and see what happens. Resist it. The gap between "the equipment is installed" and "the process is ready to prove itself" is where most pilot projects lose time, money, or credibility with stakeholders who are watching to decide whether to fund a commercial plant.

Commissioning is the disciplined bridge between those two points. Done well, it turns a newly built facility into a source of trustworthy data. Done poorly, it produces a plant that runs, but data nobody can fully rely on when it is time to seize a commercial facility.

This guide walks through what Pilot plant commissioning actually involves, how it differs from qualification and validation, and how to structure trial runs and performance testing so the pilot plant earns its keep.

Why Commissioning Deserves Its Own Plan

Many teams treat commissioning as an informal checklist tucked inside the construction schedule. That approach works fine for simple utility connections. It falls apart the moment a plant has interacting systems, meaning almost every pilot plant.

A pilot facility typically includes reactors, pumps, heat exchangers, material handling equipment, HVAC, compressed air, steam, electrical systems, and a control layer sitting on top of all of it. Each of these can pass an individual test and still cause the plant to underperform once everything runs together. Cooling capacity that looked adequate on paper might struggle once the reactor, the HVAC system, and the utility loop are all drawing on it simultaneously.

This is why commissioning needs its own scope, sequence, and acceptance criteria, developed early enough to influence engineering and procurement decisions rather than being bolted on after installation.

Getting the Terminology Right

Confusion between commissioning, qualification, and validation causes real problems, particularly in regulated sectors like pharmaceuticals, food processing, and specialty chemicals.

  • Commissioning confirms the plant is installed correctly and functions as intended.

  • Qualification (often broken into Design, Installation, Operational, and Performance Qualification) formally documents that equipment and systems perform as designed.

  • Trial runs demonstrate the process operating under defined conditions.

  • Performance testing measures how the plant actually performs against predefined targets.

  • Process validation demonstrates that the process reliably delivers consistent quality outcomes over repeated runs.

  • Scale-up assessment determines whether what was learned at pilot scale can be trusted at commercial scale.

A successful commissioning run is not proof that a process is validated, and a mechanically sound plant is not automatically a commercially viable one. Keeping these stages distinct prevents teams from declaring victory too early.

Step by Step Approach

Stage 1: Build the Commissioning Plan Before Construction Finishes

The strongest commissioning programs start on paper, well before a single motor is switched on. A solid plan defines system boundaries (raw material handling, reaction, separation, drying, utilities, automation, waste treatment), responsibilities, test sequences, documentation requirements, and a change-control process for handling the inevitable surprises.

Breaking the plant into discrete systems, each with its own commissioning status, gives everyone a shared picture of what is actually ready versus what merely looks ready.

Stage 2: Pre-Commissioning Checks

Pre-commissioning confirms the physical plant matches the design intent before anything is powered up or filled.

Mechanical and piping review:

  • Equipment installation, orientation, and alignment

  • Nozzle connections, valves, gaskets, and seals

  • Flow direction against P&IDs, drainability, and venting

  • Pressure ratings and material compatibility

Electrical review:

  • Motor control centres, panels, and cabling

  • Earthing and overload protection

  • Emergency power and interlocks

Instrumentation review:

  • Sensor and transmitter calibration status

  • Instrument ranges, alarm settings, and interlocks

Skipping this stage because equipment "looks installed" is one of the most common ways plants end up troubleshooting basic mechanical issues in the middle of an expensive trial run.

Stage 3: Don't Underestimate Utilities

Utilities are the quiet variable that derails more pilot programs than any process chemistry problem. A trial can look like a technology failure when the real issue is unstable compressed air, insufficient cooling capacity, or an electrical supply that cannot hold steady under peak load.

Before any process trial, check each utility against four questions:

  1. Capacity — can it deliver the required flow or load?

  2. Quality — does it meet the process specification?

  3. Reliability — can it hold steady conditions for the full trial duration?

  4. Backup — is there protection against interruption for anything critical?

Stage 4: Prove the Instruments and Automation Before Trusting Their Data

If the plant cannot measure what is happening inside it accurately, no amount of process expertise will produce reliable conclusions. Testing here should cover sensor calibration, control logic (PLC, DCS, or SCADA), alarms, interlocks, emergency shutdowns, and data logging or historian systems.

Measurement uncertainty deserves the same scrutiny as process uncertainty. A "successful" trial run built on miscalibrated instruments is not a success, it is a false positive waiting to be discovered at commercial scale.

Stage 5: Safety Review Before Any Material Goes In

Startup conditions change constantly, and that makes commissioning one of the riskiest phases of a plant's life. Before introducing process materials, run a formal safety review, typically a HAZOP, along with job safety analysis, chemical compatibility checks, and emergency shutdown testing.

It helps to walk through specific failure scenarios in advance: What happens if cooling fails mid-batch? If a pump stops? If pressure exceeds the safe limit? Having predefined responses to these questions before they occur, rather than improvising in the moment, is what separates a controlled commissioning program from a reactive one.

Stage 6: Dry Runs, Then Wet Runs, Then Real Material

There is a logical order to introduce risk into a new plant, and it is worth resisting the urge to skip steps.

  • Dry commissioning tests motors, pumps, valves, agitators, and control logic without any material in the system, catching mechanical and automation problems cheaply.

  • Wet commissioning introduces water, cleaning solutions, or inert substitutes to verify flow paths, leak-tightness, heat transfer, and control stability before anything valuable is at stake.

  • Trial production finally introduces the real raw materials under defined process conditions.

Stage 7: Structure the Trial Runs to Build Understanding, Not Just Repeat a Batch

A common mistake is running the same batch five times and calling it a trial program. A better approach progresses deliberately:

  1. Functional trial — confirm the process runs at all.

  2. Stabilization run — surface and address operational problems.

  3. Optimization run — improve yield, quality, and productivity.

  4. Repeatability run — check whether good results can be reproduced, not just achieved once.

  5. Scale-up evidence run — generate the specific data commercial design will need.

The right number of runs depends on process complexity and risk, not on an arbitrary industry norm. Regulators such as the FDA have made clear that validation approaches should be scientifically justified rather than tied to a fixed batch count, and the same logic applies well beyond regulated industries.

Stage 8: Measure What Actually Matters

Set acceptance criteria before the test runs, not after looking at the results. Useful categories to track include:

  • Production performance: throughput, cycle time, equipment utilization

  • Process performance: yield, conversion, recovery, residence time

  • Quality performance: purity, particle size, moisture, physical properties

  • Utility performance: power, steam, water, and compressed air consumption

  • Operational performance: downtime, changeover time, cleaning time

A simple material balance (inputs = product + by-products + waste + losses) and energy balance are worth building into every trial. They catch unexplained losses early and feed directly into commercial equipment sizing later.

Stage 9: Ask Whether the Knowledge Actually Scales

A pilot plant that runs well does not automatically mean the process will succeed at commercial scale. Heat transfer, mixing, mass transfer, and residence time distribution can all behave differently as equipment size increases. Powders and viscous materials in particular are notorious for surprising engineers who assumed pilot behaviour would hold.

Before calling a pilot program complete, the scale-up assessment should look honestly at:

  • Are critical process parameters and quality attributes clearly identified?

  • Can pilot equipment behaviour realistically translate to commercial equipment?

  • What will commercial utility loads actually be at peak demand?

  • Does the process remain economically viable once scaled?

Common Mistakes Worth Avoiding

  • Starting commissioning planning only after construction is finished

  • Testing equipment individually but never as an integrated system

  • Ignoring utility constraints until a trial run exposes them

  • Running trials without predefined acceptance criteria

  • Treating one good result as proof the process is ready for investment

  • Losing scale-up knowledge because it was never converted into engineering documentation

How IMARC Engineering Can Help

Pilot plant commissioning sits at the intersection of process engineering, equipment expertise, and project execution, which is exactly where IMARC Engineering works with manufacturers across pharmaceuticals, chemicals, food processing, electronics, and heavy manufacturing in India.

IMARC Engineering can support your pilot plant program through:

  • Commissioning plan development, including system boundaries, test sequencing, and acceptance criteria defined before trials begin

  • Pre-commissioning and utility readiness audits to catch mechanical, electrical, and utility gaps before they surface mid-trial

  • HAZOP and safety review facilitation tailored to startup-specific risks

  • Trial run protocol design, structuring runs to build genuine process understanding rather than repeat the same conditions

  • Performance testing and data analysis support, including material and energy balance verification

  • Scale-up readiness assessments that translate pilot-scale learning into commercial equipment sizing, utility planning, and CAPEX estimates

For manufacturers preparing to move from pilot to commercial investment, this connects the full chain from feasibility and process engineering through equipment selection and commercial-scale plant design.

Speak With An Expert: https://www.imarcengineering.com/contact?service=pilot-plant-setup-and-evaluation

Conclusion

Commissioning a pilot plant is not a single event, it is a sequence of deliberate checks that turns an installed facility into a source of data you can actually trust. The plants that generate the most useful commercial insight are rarely the ones that started up fastest. They are the ones where pre-commissioning was thorough, utilities were verified rather than assumed, trials were structured to build understanding rather than repeat themselves, and acceptance criteria were set before anyone looked at the results.

Treat commissioning as a risk-reduction program for your eventual commercial investment, not as a formality standing between construction and production. The extra weeks spent getting it right are consistently cheaper than the redesign costs of discovering a scale-up problem after the commercial plant is already built.


Contact Us:

IMARC Engineering

Phone: +91-120-433-0800

Email: [email protected]

India: C-130, Sector 2, Noida, Uttar Pradesh 201301

LinkedIn: https://www.linkedin.com/showcase/imarc-engineering/




0 comments

Log in to leave a comment.

Be the first to comment.
